How is Performance Percent Complete Calculated in Primavera P6?
The Performance % Complete field in P6 is utilized for Earned Value (EV) calculation and provides the percentage of the planned work that is currently completed. It serves as the initial field to assess the progress of an activity or project.

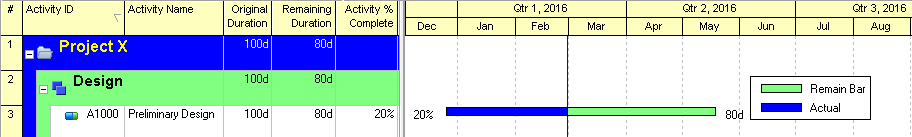

In Primavera P6, the Performance Percent Complete calculation technique is defined at the WBS level.Define which technique to use by going to Project, WBS, then selecting the Earned Value tab. This article do not explain how summary (rolled-up) performance % complete is calculated. It is discussed at this article:Why Performance % Complete doesn't roll up in Primavera P6?
